得州数据中心热潮在中期选举前遭遇反弹Texas Data Center Boom Collides With Backlash Ahead of Midterms

点「原文对照」整页切到原文,或双击某段只看那段的原文。

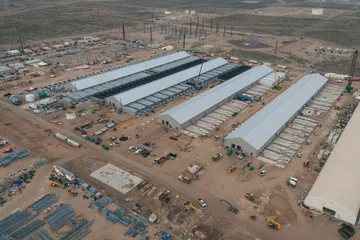

10月15日,位于得克萨斯州巴斯托的Nscale数据中心项目。The Nscale data center project in Barstow, Texas, on Oct. 15.

得克萨斯州州长格雷格·阿博特放缓数据中心建设的努力,正值选民前往投票站之际,开始见效。

Texas Governor Greg Abbott’s efforts to slow down data center construction, just as voters head to the ballot box, are starting to work.

开发商们开始寻找其他地方,此前州长突然从数据中心的拥护者转变为怀疑者。犹他州和佐治亚州等州被提及。知情人士表示,爱荷华州也被视为其项目的替代目的地。

By Shruti Date Singh, Nic Querolo, Joe Lovinger and Michelle Cheng Developers are starting to look elsewhere following the governor’s sudden pivot from data center champion to skeptic. States like Utah and Georgia come up in conversation. Iowa is also seen as an alternative destination for their projects, according to people familiar with the matter.

这可能威胁得克萨斯州的发展步伐,该州原本有望取代弗吉尼亚州成为世界数据中心之都。但随着阿博特竞选第四任期——这将使他成为该州任职时间最长的州长——因一位出人意料的强劲民主党对手而变得艰难,他改变了方向。阿博特表示,得克萨斯州的环境监管机构在该州电网运营商完成对这些申请人的审计之前,不会再向数据中心发放任何许可,所有申请人都在等待用电批准。

That could threaten the pace of development in Texas, which has been on track to usurp Virginia as the data center capital of the world. But as Abbott’s road to a fourth term, one that would make him the state’s longest-serving governor, got rockier thanks to a surprisingly strong Democratic opponent, he changed tack. Texas’ environmental regulator, Abbott said, wouldn’t hand out any more permits to data centers until the state’s grid operator completed an audit of those applicants, all of whom were waiting for approval to use power.

格雷格·阿博特 摄影师:马克·费利克斯/彭博社Greg Abbott Photographer: Mark Felix/Bloomberg

即使是最强大的公司也感受到了影响。银行正在推迟出售与得克萨斯州一家数据中心相关的债券,该数据中心将租给Anthropic PBC,该公司正在追求可能有史以来最大的首次公开募股。这家Claude的创造者本周表示,得克萨斯州的法规阻碍了其AI模型所依赖的算力扩张。

Even the mightiest companies are feeling the impact. Banks are delaying the sale of bonds tied to a Texas data center that will be leased to Anthropic PBC, which is pursuing what may be the biggest initial public offering ever. The Claude creator said this week that the Texas regulations inhibit the expansion of computing power that its AI models depend on.

阿博特曾吹嘘他的州是“AI发展的中心”,如今却在设置障碍来放缓它。

Abbott, who once touted his state as the “epicenter of AI development,” is now erecting obstacles to slow it down.

州长似乎是在回应对数据中心的广泛两党反感。许多开发商认为得克萨斯州的暂停是一个政治手段,将在中期选举后消失,但认识到需要调整对地方政府和怀疑居民的推介。

The governor is seemingly responding to a broad, bipartisan distaste for data centers. Many developers see the Texas pause as a political ploy that will evaporate after the midterm elections, but recognize the need to fine-tune their pitch to local governments and skeptical residents.

虽然数据中心能为财政拮据的城镇带来一些就业岗位,并随着时间推移带来数十亿美元的税收收入——尽管在得克萨斯州,许多项目符合税收豁免条件——但选民担心其水电消耗,一些人认为它们是推动将夺走民众生计的技术的引擎。这种张力在得克萨斯州表现得最为尖锐,该州正在进行的数据中心项目数量超过全国任何其他州。

While data centers can bring some jobs and, over time, billions of dollars in tax revenue to cash-strapped towns – though in Texas, many qualify for tax exemptions – voters worry about their water and energy use, and some see them as an engine powering technology that will steal people’s livelihoods. Nowhere is that tension more acute than in Texas, which has more data center projects in progress than any state in the country.

开发商被得克萨斯州广阔的空间及其利用太阳能、风能和天然气等电力来源的能力所吸引。JLL得克萨斯州数据中心负责人柯特·霍尔康布表示,该州向电网增加容量的能力超过美国任何其他地区。

Developers have been drawn to Texas’ ample space and its ability to tap sources like solar, wind and natural gas for electricity. The state can add more capacity to its grid than any other region in the US, said Curt Holcomb, Texas data center lead at JLL.

但现在,投资者和银行家难以弄清州长的行动对该行业在“孤星州”未来意味着什么。据一位知情人士透露,放贷方正在严格审查寻求为得州项目融资的公司,并补充称,更多投机性计划将难以吸引投资者。

But now, investors and bankers are struggling to get a grasp on what the governor’s actions mean for the industry’s future in the Lone Star state. Lenders are scrutinizing companies looking to raise financing for projects there, according to one person familiar with the matter, adding that more speculative plans will struggle to attract investors.

总部位于华盛顿的咨询公司Capstone能源与公用事业副总裁杰克·潘特表示:“得克萨斯州仍然是美国最具吸引力的数据中心市场之一。”

Texas “remains one of the most attractive data center markets in the US,” said Jack Painter, vice president of energy and utilities at Capstone, a Washington-based consulting firm.

他补充道:“这并不一定意味着你不会看到目前在ERCOT排队队列中的项目有一定比例考虑转移到亚利桑那州、犹他州或佐治亚州等地。”他指的是运营电网的得克萨斯州电力可靠性委员会。

“That doesn’t necessarily mean you don’t see some percentage of what’s currently in the ERCOT queue consider shifting to, let’s say, an Arizona or a Utah or a Georgia,” he added, referring to the Electric Reliability Council of Texas, which operates the grid. “Governor Abbott’s position is clear: Texans come first,” a spokesperson for his office said.

“阿博特州长的立场很明确:得州人优先,”其办公室发言人表示。“数据中心必须自负盈亏,保护我们的电网和水资源,并完成州政府审计。在此之前,任何州政府机构都不会发放相关许可,任何未达到这些标准的项目都将被拒。”

“Data centers must pay their own way, protect our grid and water, and complete the state audits. Until they do, no state agency will issue related permits and any project that fails those standards will be denied.”Some developers have filed complaints over delays that they say put their deals at risk because of the audits.

一些开发商已就延误提出投诉,称审计使其交易面临风险。其中包括土地开发商 Tract 公司,该公司原本预期获得批准,将一座拟建的 500 兆瓦数据中心(位于圣安东尼奥附近)接入电网,但上个月被告知州监管机构要求对该场地进行更多评估。

That includes land developer Tract, which was expecting approvals to connect a proposed 500-megawatt data center near San Antonio to the grid, but was told last month that state regulators want more evaluations for the site. The Colorado-based company’s 265-acre development in Medina County, one of its 14 active projects across seven states, is now caught up in a dispute with ERCOT.

这家总部位于科罗拉多州的公司在梅迪纳县拥有一个 265 英亩的开发项目,这是其跨七个州的 14 个在建项目之一,目前陷入了与 ERCOT(得州电力可靠性委员会)的纠纷中。

“Any delay of this proceeding beyond the conclusion of ERCOT’s audit and verification process will cause irreparable harm,” Tract wrote in a Sept. 30 complaint filed with the Public Utility Commission of Texas.

“如果该程序在 ERCOT 完成审计和核查流程后仍被延迟,将造成不可挽回的损害,”Tract 公司在 9 月 30 日向得州公用事业委员会提交的投诉中写道。要求公司进行更多研究“不仅仅是延误几个月,可能会扼杀一个项目。”总部位于丹佛的数据中心开发商 Rowan Digital Infrastructure 也在质疑 ERCOT 的审查,该审查是在其获得“Stampede 项目”初步批准一年后进行的,该项目是奥斯汀以北一座 42 亿美元数据中心园区的一部分。

Requiring more studies from the company “is not just a delay of a few months, it could kill a project.”Rowan Digital Infrastructure, a Denver-based data center developer, is also challenging the ERCOT review, which came a year after it received initial approval for “Project Stampede,” part of a $4.2 billion data center campus north of Austin. The pause creates a “material risk that the project loses access to additional financing because of the regulatory uncertainty,” Rowan wrote in a complaint.

Rowan 公司在投诉中写道,暂停造成了“实质性风险,即因监管不确定性导致项目失去获得额外融资的机会”。“政治原因”一些分析师和开发商认为,阿博特的行动可能更多是一种政治手段,而非真正旨在放缓该州对数据中心的接纳,后者引起了大多数选民的反感。得州大学和得州政治项目的一次民调显示,57% 的得州人反对在其社区建设数据中心。

‘Political Reasons’Some analysts and developers suggest that Abbott’s actions may be more of a political maneuver than a genuine effort to slow the state’s embrace of data centers, which rankles a majority of voters. A poll from the University of Texas and the Texas Politics Project found that 57% of Texans oppose the construction of one in their community.

民主党州长候选人吉娜·伊诺霍萨在竞选中利用了这种不满情绪,呼吁暂停数据中心的开发。她在民调中仅落后阿博特几个百分点,这让她真正有机会赢得该党自1990年以来从未赢得过的职位。

Gina Hinojosa, the Democratic nominee for governor, has channeled that discontent in her campaign by calling for a moratorium on data center development. She’s only a few points behind Abbott in the polls, giving her a real shot to claim a position the party hasn’t won since 1990.

“格雷格·阿博特在数据中心问题上的强硬言论不过是选举年的噱头,”伊诺霍萨本月早些时候说。“阿博特用全国最丰厚的税收优惠把这些数据中心吸引到得克萨斯州,然后为了政治利益假装暂停审批。”总部位于达拉斯的开发商DataBank的首席执行官劳尔·马蒂内克也认为,阿博特冻结许可的背后是“政治原因”。

“Greg Abbott’s tough talk on data centers is nothing more than an election year stunt,” Hinojosa said earlier this month. “Abbott invited these data centers to Texas with the richest tax breaks in the country, and then pretended to pause approvals for political gain.”Raul Martynek, chief executive officer of Dallas-based developer DataBank, also believes “political reasons” are behind Abbott’s permit freeze.

吉娜·伊诺霍萨Gina Hinojosa

“他需要把这件事拖过选举,然后才能从那里恢复,”马蒂内克说。

“He needed to kick the can past the election and then be able to resume from there,” Martynek said.

DataBank已在得克萨斯州开发了近350兆瓦的数据中心设施——足以为近9万户得州家庭供电——尽管有新法规和接入电网的长队,该公司仍在推进该州的项目,并预计该州仍将是新设施的首选目的地。马蒂内克认为,额外的审查将淘汰一些更具投机性的开发商,这些开发商在没有能力完成项目的情况下就申请大量电力。

DataBank, which has already developed almost 350 megawattsof data center facilities in Texas — enough to power almost 90,000 Texas homes— is still pursuing projects in the state and expects it to remain a top destination for new facilities, despite the new regulations and long queue to connect to the grid. Martynek sees the added scrutiny shaking out some of the more speculative developers who file requests for significant power without the capacity to complete their projects.

此外,实施审计有助于推迟ERCOT的一份报告,该报告原本会在11月3日选举前预测包括数据中心在内的高容量工业消费者的电力需求。

Plus, implementing the audit helped to postpone a report from ERCOT that would have forecast power demand from high-capacity industrial consumers – including data centers – just before the Nov. 3 election.

“任何关于这个数字的头条新闻都可能影响他的连任竞选,并进一步激怒选民,”Capstone的佩因特说。“审计最终把这些头条新闻推迟到了选举之后。”

“Any headlines about that number would have potentially impacted his reelection bid and frustrated voters even more,” Capstone’s Painter said. “The audit ultimately pushed those headlines until after the election.”
